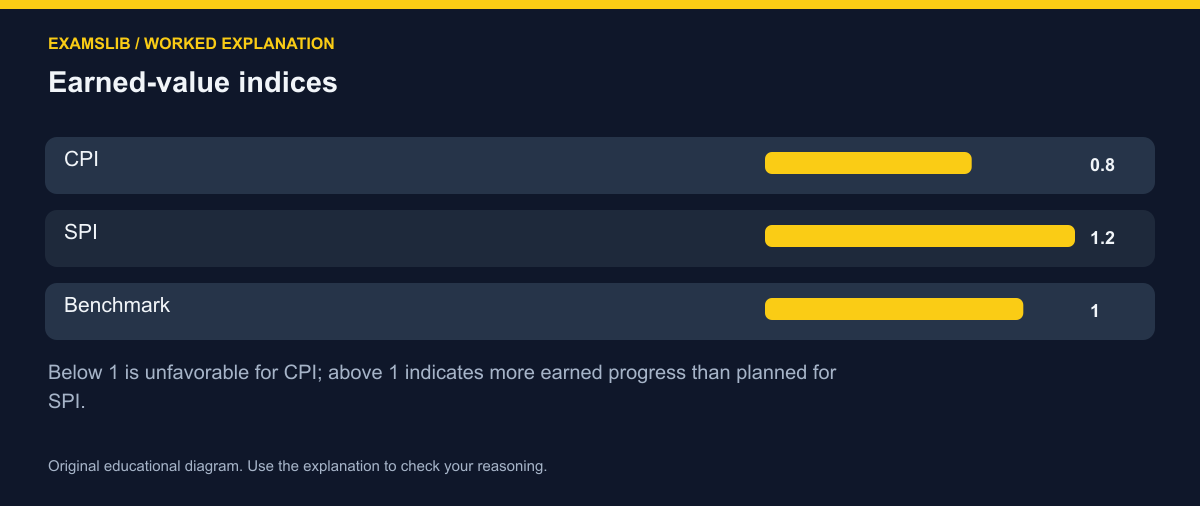

Practice walkthrough
For a progress-report exercise, earned value is $48,000, actual cost is $60,000, and planned value is $40,000. Using CPI = earned value / actual cost and SPI = earned value / planned value, which interpretation is correct?
Answer: Cost efficiency is below plan; schedule progress is ahead of plan
CPI is $48,000 / $60,000 = 0.80, meaning less earned value per actual dollar than the benchmark of 1. SPI is $48,000 / $40,000 = 1.20, meaning more value earned than planned by this date. These indices describe different dimensions; a project can be ahead in earned progress while spending inefficiently.

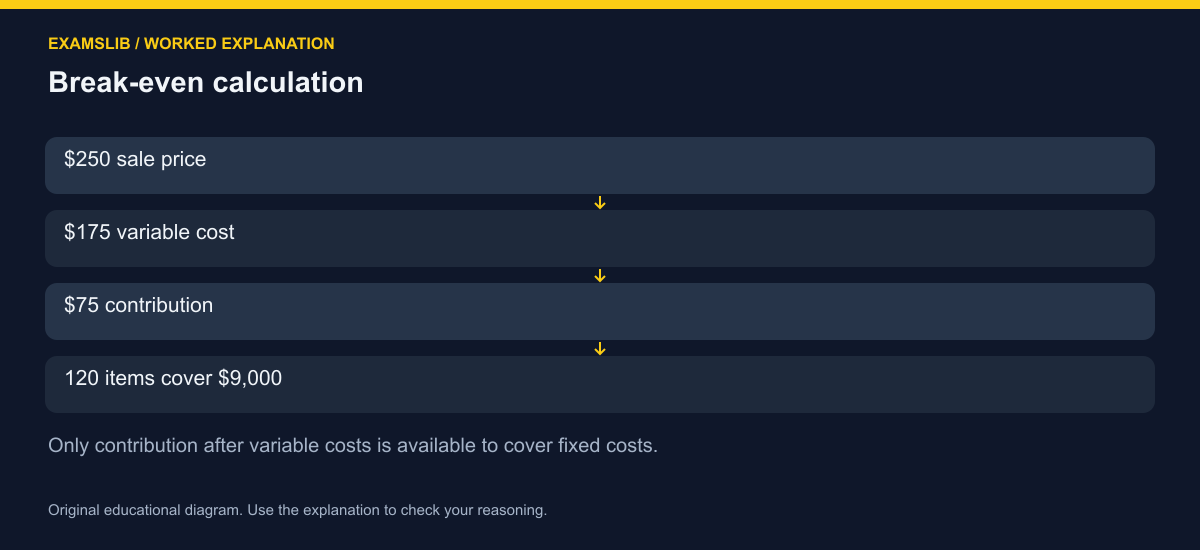

Practice walkthrough
A workshop has monthly fixed costs of $9,000. Each completed item sells for $250 and has variable cost of $175. Assuming every item is sold, how many items are needed to break even?
Answer: 120 items
Contribution per item is selling price minus variable cost: $250 − $175 = $75. Fixed costs require $9,000 / $75 = 120 items to cover. Dividing fixed costs by the selling price ignores the variable costs that must also be paid.
